How Long Does a Website Take in Korea? Week by Week

A Korean website takes 4–10 weeks to build, but payment, KakaoTalk and login reviews set the launch date. Start them in week one. The week-by-week plan.

A Korean company website typically takes 4–10 weeks to build, a one-page landing page 1–3 weeks and a web app 6–12 weeks, in our pricing catalogue. What decides the launch date is usually not the build but the Korean reviews that run alongside it: the payment gateway contract, KakaoTalk template review (Kakao processes it within two business days), Kakao and Naver login reviews (three to five and two to three business days) and Naver indexing (up to a week after its crawler visits). Start those in week one and the build sets the pace.

Line drawing of a calendar with week columns and bars of different lengths running in parallel, with a flag at the end
A Korean launch is the build plus the Korean reviews that run beside it.

This page lays out a week-by-week plan, what each step needs from you, and what to start early so nothing waits at the end.

How long does it take to build each type of project?

These are the build times in our pricing catalogue (version 1.1). They assume the content is mostly ready and decisions come back within a few days.

ProjectTypical build time
One-page landing page1–3 weeks
Company website (around 6–9 pages)4–6 weeks
Larger company, institution or society site (around 10–15 pages, two-level menus)6–10 weeks
Web app or platform with sign-in and admin6–12 weeks
Internal business system, one workflow end to end4–10 weeks

Each module adds development days: a one-time payment integration 3–5 days, recurring payments 5–10, social login 1–3, phone identity verification 3–4, KakaoTalk and SMS notifications 2–4, and a second language 2–4.

What does a week-by-week plan look like?

This is a typical plan for a bilingual company website with an inquiry form, KakaoTalk notifications and Korean payments.

WeekBuildKorean services (start early)What we need from you
1Scope, sitemap and feature list agreedPayment gateway application; KakaoTalk Channel createdCompany documents for the applications; final feature list
2Design conceptAlimTalk templates drafted and submittedFeedback on the concept; logo and brand files
3Design revisions; development startsKakao and Naver login apps set up, reviews requested if neededApproval of the design
4–5Pages, admin (CMS) and forms builtPayment contract in reviewKorean and English content
6Payments and notifications wired with test keysLive payment keys once the contract is activeTest orders and inquiries from your side
7QA on desktop and phones, content entryNaver Search Advisor and Google Search Console registeredFinal sign-off
8LaunchSitemaps submitted; Naver reflects pages within up to a week after its crawler visitsAnnounce

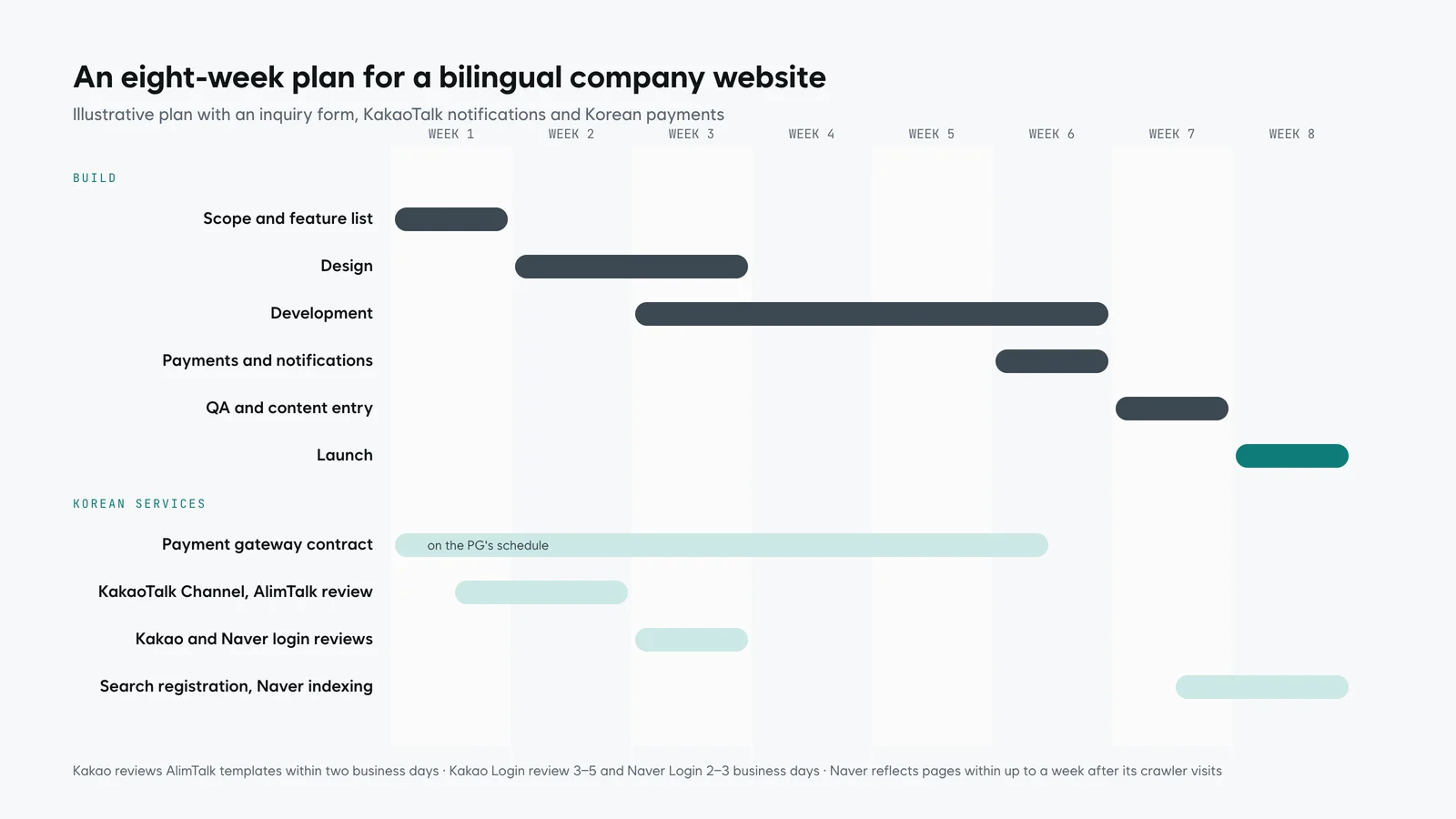

Gantt chart over eight weeks with rows for scope, design, development, payments and notifications, QA and launch on the build track, and payment contract, KakaoTalk Channel and AlimTalk review, login reviews and Naver indexing on the Korean services track
An eight-week plan. The Korean services track starts in week one, not after the build.
Have a launch date in mind? Write to us in two minutes with the date and what the site has to do. No brief needed; we will tell you whether the date works and what to start now.

Which Korean reviews take the longest?

ReviewPublished or stated timingStart it
Payment gateway contractOn the PG's schedule: application, document review, contract review, card company reviewWeek 1
KakaoTalk AlimTalk templatesKakao processes reviews in order within two business days; a rejection restarts the reviewWeek 2
Kakao Login extra consent itemsKakao says review typically takes three to five business daysWeek 3
Naver Login app reviewNaver says results arrive within two to three business daysWeek 3
Phone identity verification registrationSystem registration takes up to one business day after the contractWhen the contract is signed
Naver indexingNaver says content is reflected within up to one week after the crawler visitsAt launch

The payment contract is the one to watch. It needs Korean company documents, and payment cannot go live until it is active, so it is the most common reason a finished site waits.

What slows a Korean launch down?

  • Content that is not ready. Korean and English text, product details and images are the most common cause of delay. Our prices assume you provide translations.
  • Late decisions on payments. Choosing between a Korean PG, Stripe or Eximbay in week six moves the launch. Our Stripe in Korea guide and Korean payment gateways compared help you decide in week one.
  • Missing company documents. Korean services ask for the Korean business registration and corporate documents. Prepare them before the applications.
  • Rejected templates or reviews. A rejected AlimTalk template or login review needs a fix and a new review. Leave room for one round.
  • Scope added mid-build. A new feature is a written change request with its own estimate and schedule impact.

Can it be done faster?

Sometimes. If the schedule is tight, you can ask for rush intake when we have the availability, and a landing page can go live first while the full site is built. What cannot be shortened is the providers' own reviews, which is why they start in week one. If our schedule is full, we tell you when we can start in the first conversation.

How we run Korean launches

We are a two-person studio in Korea; our CEO and a director design and build each project themselves. On the Korean side, we prepare the applications and handle the Korean-language communication for payment gateways, the KakaoTalk Channel and Naver Search Advisor, while your company stays the contracting party. Our English-speaking founder runs consultations and documents directly, and we can meet you in person in Korea.

For the full list of what a Korean launch needs, start with Korea market entry. For prices, see website development cost in Korea.

Frequently asked questions

How long does it take to build a website in Korea?

In our catalogue, a one-page landing page takes 1–3 weeks, a company website 4–6 weeks, a larger institution or society site 6–10 weeks and a web app 6–12 weeks, assuming content is mostly ready.

How long does a Korean payment gateway take to approve?

It runs on the gateway's schedule: application, document review, contract review and card company review. Start it in week one with your Korean company documents ready, so it finishes before the build does.

How long does KakaoTalk AlimTalk template review take?

Kakao processes template reviews in order within two business days of submission. A rejected template has to be edited and resubmitted, which starts a new review.

How long does Naver take to index a new website?

Naver says content is reflected in search within up to one week after its crawler visits. Register the site in Naver Search Advisor and submit a sitemap at launch so the visit comes sooner.

Can we launch a landing page first?

Yes. A one-page landing page takes 1–3 weeks in our catalogue and can collect inquiries while the full site or web app is built.

Sources

Planning a launch date?

Write to us in two minutes with your date and what the site needs to do: no brief needed. If you have a sitemap, content or designs, send them with the project request form. To outline the scope and see an estimated timeline yourself, use the estimator.

Planning a similar project?

Send us your goals, scope and timeline. The two of us who would build it reply directly.

Prefer email? Write to nqsolutionai@gmail.com — the founder replies directly.
